Second Music City Loop Construction Update Marks Major Milestones Ahead of Tunneling

The Boring Company has released its second bimonthly update on the Music City Loop, detailing substantial progress on construction, permitting, environmental review, and community engagement. With the first TBM now installed in Nashville, tunneling could begin as early as January. [Read more ➝]

By the LOOP Nashville Editorial Staff

12/3/20254 min read

Source: Music City Loop Blog – December 2025

The Music City Loop project has reached a series of major milestones as The Boring Company (TBC) releases its second official construction update. The December blog post details advances in construction, design, environmental review, and public engagement since the October 1 update, reflecting how the project is transitioning from preparation to near-term tunneling.

The update follows a 1 hour and 40 minute live X Spaces conversation hosted on November 24, during which TBC leaders offered an extended briefing on the system’s progress and answered questions from Nashville residents. Together, the blog and the public forum provide the most comprehensive view to date of what is happening beneath the Capitol Hill work zone and along the future tunnel alignment.

Construction Progress and TBM Installation

One of the most significant developments since October is the completion of the tunnel boring machine launch shaft at Lot 16. Controlled blasting brought the shaft to its final depth, marking the end of excavation and shoring work. TBC emphasized that this milestone was reached through close coordination with the Tennessee Department of General Services, TDOT, NDOT, and the Office of the State Architect to ensure that blasting could proceed safely and predictably.

Immediately following completion of the launch pit, Nashville received its first tunnel boring machine. Prufrock-MB1 arrived from TBC’s Bastrop facility, was fully assembled onsite, and has now been lowered into the launch shaft. Final system checks are underway, and the machine is technically ready to begin tunneling on December 15. TBC noted that actual launch timing depends on the remaining permit reviews, making January the most likely window for the first mining operations.

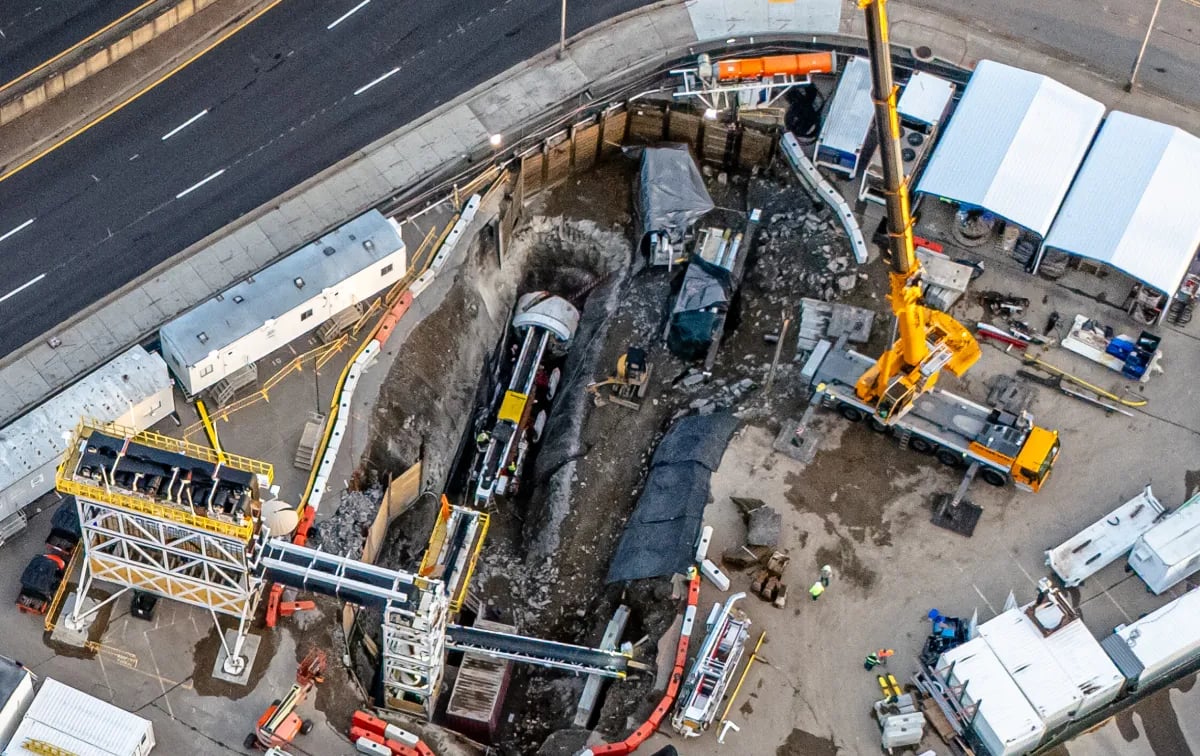

Just above the shaft, the conveyor system responsible for removing excavated material is now fully installed. The Vertical Cassette, which plays a central role in spoil removal, has been calibrated and tested. Images posted by TBC show the scale of the equipment and the continued buildout of the work site ahead of active mining.

Design and Permitting Continue to Advance

Design, engineering, and permitting activities have progressed in parallel with construction. The Music City Loop requires 45 total permits and approvals for tunnel construction alone. According to the update, 27 of those permits have already been approved, and another 10 are under review by various city, state, and federal agencies. The remaining eight relate to future launch sites needed for completion of the Broadway and Airport alignments.

TBC also recently announced the planned Broadway expansion. The proposed route would extend southwest from Lower Broadway, follow West End Avenue past Centennial Park and Vanderbilt University, and end near Interstate 440. Additional potential expansions continue to be evaluated based on Nashville’s transportation needs and community feedback.

Supporting these design efforts is extensive geotechnical and utility investigation. Crews have completed 17 exploratory core borings, seven MASW surveys, and a review of 174 historical borings and seven private reports. Fieldwork to verify utilities along the alignment is ongoing, helping reduce the risk of conflicts once tunneling begins. Coordination with TDOT also continues on both the tunnel construction permit and the long-term lease agreement needed for tunnel operations beneath state right-of-way. The lease agreement requires federal approval, and review by the Federal Highway Administration is underway.

Environmental Review Shows No Meaningful Impacts

A major milestone highlighted in the update is the completion of an independent Environmental Impact Assessment (EIA), followed by a separate review conducted by a third-party evaluator. The EIA analyzed potential impacts across categories such as noise, vibration, air quality, hazardous materials, cultural resources, aquatic resources, geology, utilities, land use, transportation, and potential effects on sensitive populations. The assessment found positive impacts in several areas and no meaningful impacts in all others.

TBC noted that tunneling offers unique environmental benefits, allowing major infrastructure to be built without closing lanes, creating construction noise, or producing surface vibration. The final transportation system will be fully electric, producing zero tailpipe emissions and operating with high energy efficiency. Both the EIA and the independent review will be published on the Music City Loop website by December 15.

Safety Measures and Clarifications

Safety remains the central priority for the project, and TBC used the update to address recent inaccurate reports. The company stated that a review of approximately 240 site entries over a two-week period found that employees were in full compliance with personal protective equipment requirements. Eight instances of non-compliance involved contractors, each of whom was immediately removed from the project until the issue was corrected.

TBC also clarified that the shoring system in the launch pit consists of more than 20,000 pounds of steel soldier piles embedded into the rock, supported by engineered wood lagging and concrete. This approach is an industry-standard method designed by Tennessee-licensed structural engineers and built with high safety margins. To date, there have been no injuries, safety incidents, or on-site issues.

In addition to workplace safety, TBC continues to advance long-term safety innovations, including the pursuit of ZPIT (Zero-People-In-Tunnel) boring machines. While the newest Prufrock model requires only three people inside the tunnel, the goal is to fully eliminate the need for personnel in the tunnel during active mining. Emergency preparedness planning also continues in partnership with the Nashville Fire Department and the Tennessee Mine Rescue Association, whose Tunnel Rescue Team has provided equipment and will lead emergency response drills.

Community Engagement Expands Across Nashville

The December update highlights continued outreach across the city. TBC holds weekly coordination meetings with commissioners and staff from eight state departments, has met with leadership in at least ten Metro departments, and has spoken directly with more than 20 members of the Metro Council. Engagement with community organizations continues to grow, now exceeding 130 groups, universities, nonprofits, and professional associations. The team has participated in more than 50 volunteer events and delivered presentations to thousands of Nashvillians. More than 100 public inquiries have been answered through the project’s dedicated email address.

Interest in station development has also grown. More than 30 potential station locations are now in various stages of design, each developed collaboratively with property owners to ensure safe operations, efficient vehicle flow, and accessible pedestrian connections.

Remaining Items Under Review

The update notes that several items remain under active coordination to prevent potential delays. These include approvals required for crossings beneath TDOT and CSX structures, continued negotiations on the Airport alignment agreement, federal review of the tunnel lease agreement, and ongoing discussions with property owners regarding station locations.

Looking Ahead

With the launch shaft complete, Prufrock-MB1 installed, half of the required permits approved, and environmental review now concluded, the Music City Loop is approaching the start of full tunneling operations. The December blog post reflects significant momentum as Nashville prepares to enter the next phase of building a new underground transportation network.
